Flat-Pack Containers
Containers

Demountable Container Systems

Flat-Pack Containers Where Transport Distance Drives the Decision

Modular units shipped flat and assembled on arrival, planned around freight economics, bolted assembly sequence, joint execution, component protection, anchorage, and repeated deployment.

Planning basis
Quantity, destination, freight route, and units per load
Assembly model
Bolted and interlocking components raised with hand tools
Delivery model
Flat-packed shipment, site assembly, testing, and anchorage
Shipped flat, assembled on arrival

Flat-Pack Containers Where Transport Distance Drives the Decision

A flat-pack container is the same building broken down into panels, frame members, and fixings, packed flat, and assembled at destination. The construction and specification match an assembled unit; what changes is where the final assembly happens and how many units fit on a load.

The advantage becomes decisive on long overland routes, sea freight, and projects in remote locations. Energy, mining, road, dam, and airport programmes frequently move accommodation and facilities across borders, and shipping several flat-packed units in the space occupied by one assembled unit changes the delivered cost rather than the list price.

Assembly relies on bolted and interlocking connections rather than site welding, so a small trained crew can raise a unit with hand tools and no hot work permit. The same connections allow clean dismantling, which is what makes moving units between project phases realistic.

Many more units per load

Because panels and frame members travel flat, a single trailer or shipping container carries several units instead of one, which is where the saving appears on long routes.

Bolted and interlocking assembly

Components are joined with bolts and locating profiles rather than site welding, so a small crew can raise a unit with hand tools and no hot work permit.

Dismantled and reused

The same connections that allow fast assembly allow clean dismantling, so units can be flat-packed again and shipped to the next phase of a programme.

From pallet to building

Assembly Sequence of a Flat-Pack Unit

The sequence matters as much as the components. Squareness established early carries through every panel, and a joint sealed out of order is difficult to correct afterwards.

  1. 01

    Base Preparation

    Levelled pads, slab, or prepared bearing points set out to the unit grid, with drainage and service positions agreed before the load arrives.

  2. 02

    Unloading and Sorting

    Panels, frame members, and fixings unloaded and laid out in assembly order, with a check against the packing list before work starts.

  3. 03

    Base Frame

    Chassis members bolted and squared on the prepared bearing points, with levels verified before any vertical element is raised.

  4. 04

    Corner Posts and Frame

    Corner posts and top frame bolted into position, establishing the dimensional accuracy that every subsequent panel depends on.

  5. 05

    Wall Panels

    Insulated panels located into the frame profiles, sequenced so that door and window panels land in their planned positions.

  6. 06

    Roof and Sealing

    Roof panels fixed with the seam arrangement sealed, edge trims fitted, and falls checked before the unit is considered weathertight.

  7. 07

    Services Connection

    Pre-wired components joined, distribution board energised, circuits tested, and any plumbing connected and pressure checked.

  8. 08

    Anchorage and Handover

    Unit fixed to the base against wind uplift, unit-to-unit connections made where combined, and documentation issued at completion.

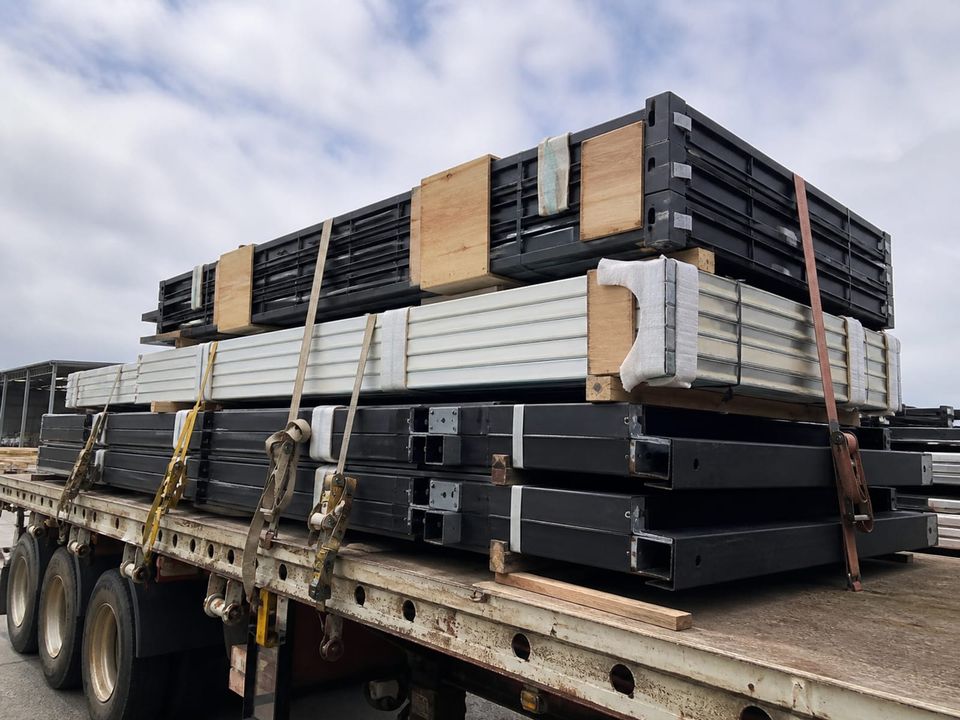

Flat-packed container components stacked and restrained for transport
Packing method, edge protection, load restraint, and a checkable packing list determine how much damage appears when the load is opened.

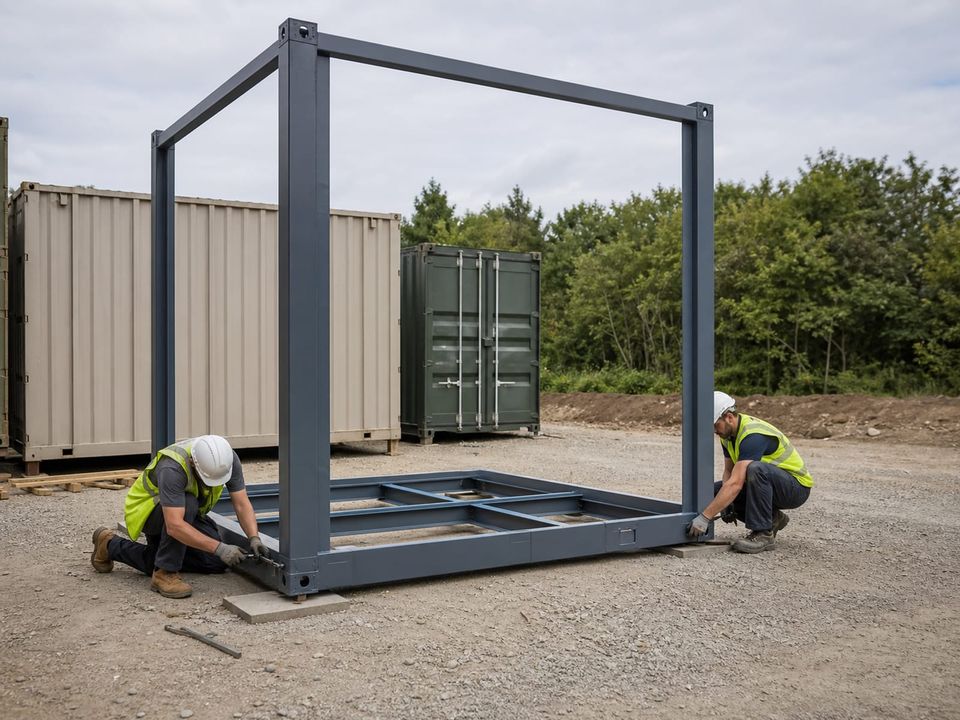

Crew bolting a flat-pack container base frame and corner posts on prepared pads
Base frame and corner posts establish the squareness every subsequent panel depends on, which is why levels are verified before anything vertical is raised.

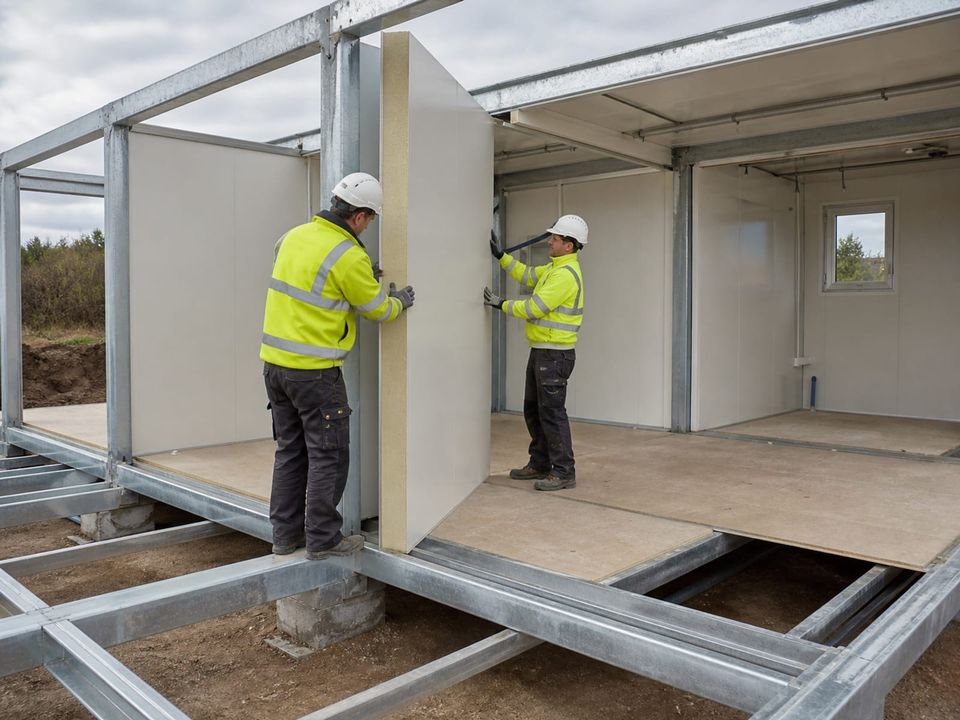

Insulated wall panels being located into frame profiles during flat-pack assembly
Panels locate into frame profiles in a planned sequence so that door and window positions land correctly without rework.
Planning before shipment

Decide Who Assembles, and Prepare the Base Before the Load Arrives

The brief should record the number of units, the destination, the freight route, the units achievable per load, and the assembly arrangement. Flat-pack only pays when the transport saving exceeds the cost and risk of assembling at destination, so those figures should be compared before the method is chosen.

Assembly responsibility should be explicit. Whether units are erected by the supplier, by a supervised local crew, or by the client's own team changes the documentation, the training, the tools supplied, and where responsibility sits if a unit does not perform as specified.

Base preparation is the most common cause of delay on arrival. Levelled bearing points set out to the unit grid, cured foundations, drainage positions, and service routes should all be complete before the load lands, because a flat-pack delivery cannot simply be placed and left like an assembled unit.

Weathertightness depends on execution. Every joint made on site was made in a factory on an assembled unit, so joint profiles, seals, roof seam arrangement, and penetration detailing must be carried out as specified. Assembly documentation and inspection hold points are worth agreeing in the contract.

Whole-delivery performance

Freight Saving, Assembly Quality, and Reuse

The value of a flat-pack programme depends on transport economics, assembly discipline, joint execution, component protection, anchorage, and how well units survive repeated deployment.

01

Transport economics

The advantage is measured in units per load, not in unit price. On long overland routes or sea freight, shipping several flat-packed units in the space of one assembled unit changes the delivered cost materially.

02

Assembly quality on site

A flat-pack unit is only as good as its erection. Sequence, squareness, torque where specified, panel seating, and sealant application at joints determine whether the finished unit performs as designed.

03

Weathertightness at joints

Every joint made on site is a joint that was made in the factory on an assembled unit. Joint profiles, seals, roof seams, and penetration detailing need to be executed as specified rather than improvised.

04

Component protection in transit

Panels, glazing, and coated members travel unprotected by a structure. Packing method, edge protection, load restraint, and handling on arrival determine how much damage shows up at assembly.

05

Anchorage and stability

A light unit assembled on site still has to resist wind uplift and overturning. Base fixing, anchorage detail, and any temporary bracing during erection should be defined rather than left to the crew.

06

Reuse and component tracking

Repeated assembly and dismantling wears fixings, seals, and panel edges. A defined inspection list, replaceable seal specification, and spare component stock keep units serviceable across several deployments.

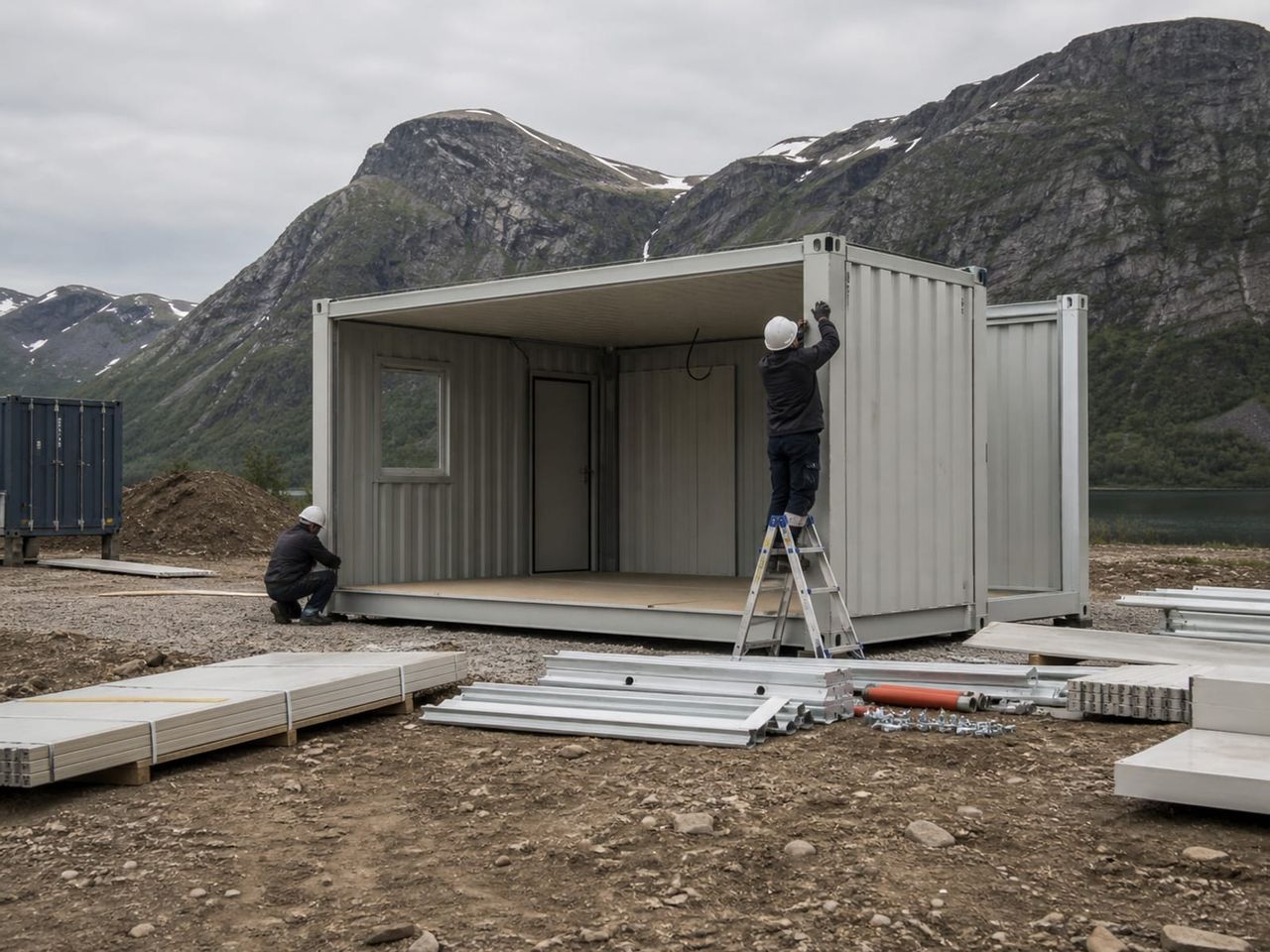

Flat-pack container assembly on a remote project site with a small crew and hand tools
Assembly planning should coordinate base preparation, unloading and sorting, erection sequence, sealing, service connection, testing, anchorage, and the documentation issued at completion.
A comparable and complete delivery scope

What Shapes a Flat-Pack Container Quotation?

A meaningful quotation begins with an agreed quantity, destination and freight route, unit specification, assembly responsibility, site preparation, and packing scope. Compare proposals on delivered and assembled cost rather than unit price alone.

01Quantity and destination

Number of units, delivery location, route, freight method, customs requirements, and the units achievable per load.

02Unit configuration

Dimensions, internal layout, openings, partitions, combination arrangement, and whether stacking is required at destination.

03Envelope specification

Panel core and thickness, facing, coating system, roof arrangement, floor build-up, glazing, and door specification.

04Assembly responsibility

Who erects the units, supervision provision, tools and equipment supplied, training, and the assembly documentation issued.

05Site and exposure

Ground conditions, base preparation, wind and snow actions, corrosion category, access, levelling, and anchorage design.

06Services scope

Pre-wired components, distribution, lighting, sockets, plumbing where included, connection method, testing, and certification.

07Packing and protection

Packing method, edge and glazing protection, load restraint, packing list, spare fixings, and damage reporting procedure.

08Commercial boundaries

Allowances, exclusions, approvals, warranties, documentation, spare parts, reuse expectations, and change procedures.

Flat-pack delivery questions

Flat-Pack Containers FAQ

Clear answers about freight saving, assembly, crew requirements, weathertightness, base preparation, reuse, and quotation scope support a more reliable delivery brief.

When is flat-pack the right choice?

Flat-pack pays when the transport saving exceeds the cost and risk of assembling at destination. On long overland routes, sea freight, and remote projects it is usually decisive, because several flat-packed units travel in the space occupied by one assembled unit.

How many units fit in one load compared with assembled units?

The exact figure depends on unit size and packing method, but the whole point of the method is that panels and frame members travel flat rather than around an air-filled volume. The comparison that matters is delivered cost per unit, which the supplier should state for your specific route.

Who assembles the units?

Assembly can be carried out by the supplier, by a supervised local crew, or by the client's own team. This should be explicit in the contract, because it changes the documentation, training, tools supplied, and where responsibility sits if a unit does not perform as specified.

What equipment is needed for assembly?

Because connections are bolted and interlocking rather than welded, a small trained crew can raise a unit with hand tools and lifting aids, without hot work permits. Site conditions, unit size, and stacking requirements may still call for mechanical lifting equipment.

Is a flat-pack unit as weathertight as an assembled one?

It can be, but only if the joints are executed as specified. Every joint made on site was made in the factory on an assembled unit, so joint profiles, seals, roof seam arrangement, and penetration detailing determine the result. Assembly documentation and inspection hold points are worth agreeing.

What has to be ready before the load arrives?

Levelled bearing points set out to the unit grid, cured foundations, drainage positions, and service routes should all be complete. A flat-pack delivery cannot simply be placed and left like an assembled unit, so unprepared sites cause immediate delay.

Can units be dismantled and shipped again?

Yes, which is one of the main reasons for choosing the method on multi-phase programmes. Repeated assembly wears fixings, seals, and panel edges, so an inspection list, replaceable seal specification, and spare component stock keep units serviceable across deployments.

What should a flat-pack quotation include?

A comparable quotation states quantity and destination, units per load, unit specification and envelope build-up, assembly responsibility and supervision, site preparation requirements, packing and protection method, and the commercial exclusions.
