Steel Home Technical Specifications
Steel Homes

Specification Guidance

Steel Home Technical Specifications and Why They Decide the Outcome

A guide to the document a quotation should answer, covering scope, structural criteria, frame and coating, envelope assemblies, thermal bridging, fire and acoustic targets, services, testing, and warranty.

Purpose
Turns descriptions into requirements that can be priced and inspected
Coverage
Scope, structure, materials, envelope, services, compliance, testing
Outcome
Comparable quotations and defined warranty and documentation
The document a quotation should answer

Steel Home Technical Specifications and Why They Decide the Outcome

A technical specification converts a general description of a house into requirements that can be priced, manufactured, inspected, and compared. It records the intended use, structural criteria, materials, envelope build-ups, services, compliance route, testing, and handover documentation.

Words such as well insulated, high quality, or earthquake resistant are not comparable between suppliers because they define neither construction nor measurable performance. A specification replaces them with values, standards, and the method by which each will be demonstrated.

It also protects the buyer at the point where protection is still possible. Warranty scope, documentation, commissioning records, and maintenance obligations are straightforward to agree before an order and very difficult to negotiate after handover.

Turns adjectives into figures

Terms like well insulated, high quality, and earthquake resistant describe nothing measurable. A specification replaces them with values, standards, and test methods.

Makes quotations comparable

Two proposals can only be compared when they answer the same document. Without one, the lowest price usually reflects the smallest scope rather than better value.

Defines what happens after handover

Warranty scope, documentation, commissioning records, and maintenance obligations belong in the specification, because that is when they are still negotiable.

What the document contains

Sections of a Steel Home Specification

Each section should be precise enough to be verified on site, because a requirement that cannot be checked is a requirement that will not be met.

  1. 01

    Scope and Intended Use

    Permanent dwelling or seasonal use, occupancy, number of storeys, gross and net floor areas, and the expected design service life.

  2. 02

    Structural Criteria

    Design standard, seismic parameters for the site, wind and snow actions, imposed loads, deflection and vibration limits, and who verifies the design.

  3. 03

    Frame and Protection

    Steel grade, section profiles and thickness, galvanised coating class, connection type, bracing arrangement, hold-downs, and cut-edge treatment.

  4. 04

    Foundation and Anchorage

    Foundation type, ground investigation basis, bearing assumptions, anchorage detail, damp-proofing, and the boundary of responsibility for the works.

  5. 05

    Envelope Build-Ups

    Wall, roof, and floor assemblies layer by layer, insulation type and thickness, continuity across the frame, vapour and air control, and target U-values.

  6. 06

    Openings and Glazing

    Window and door systems, frame material, glazing composition, thermal and solar performance, safety glass, ironmongery, and installation detailing.

  7. 07

    Services Installation

    Electrical distribution and circuits, heating and cooling equipment and capacity, hot water, ventilation strategy, plumbing, drainage, and controls.

  8. 08

    Testing and Handover

    Inspection hold points, air tightness test, electrical certification, commissioning records, as-built drawings, warranty scope, and maintenance manual.

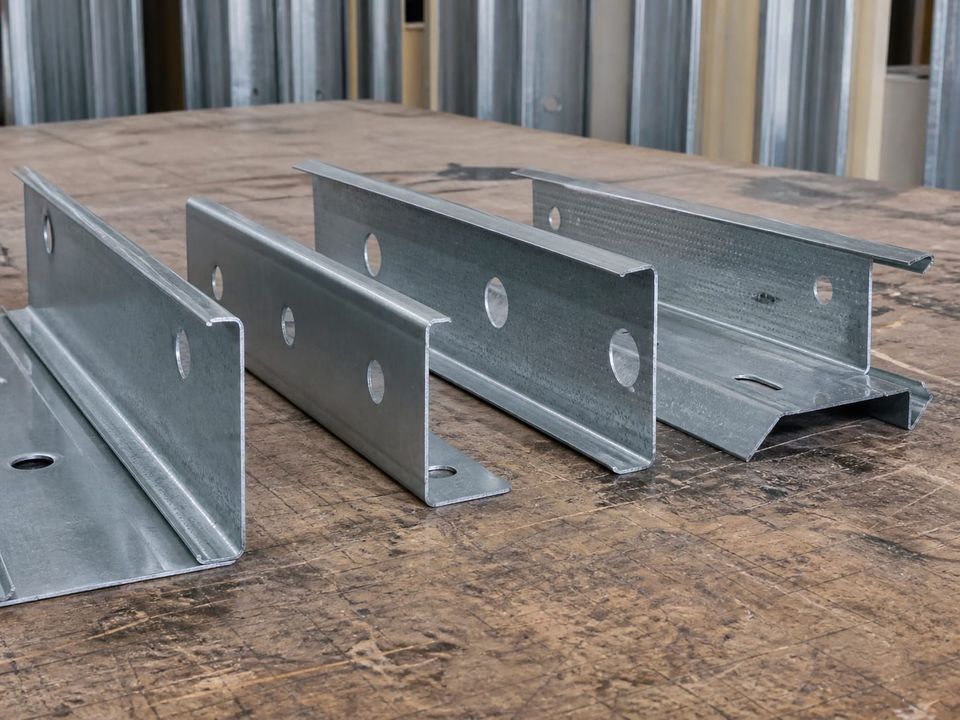

Light gauge steel sections showing profile, thickness, and galvanised coating
Steel grade, section profile and thickness, and coating class should be stated with traceability so installed material can be checked against the approved submission.

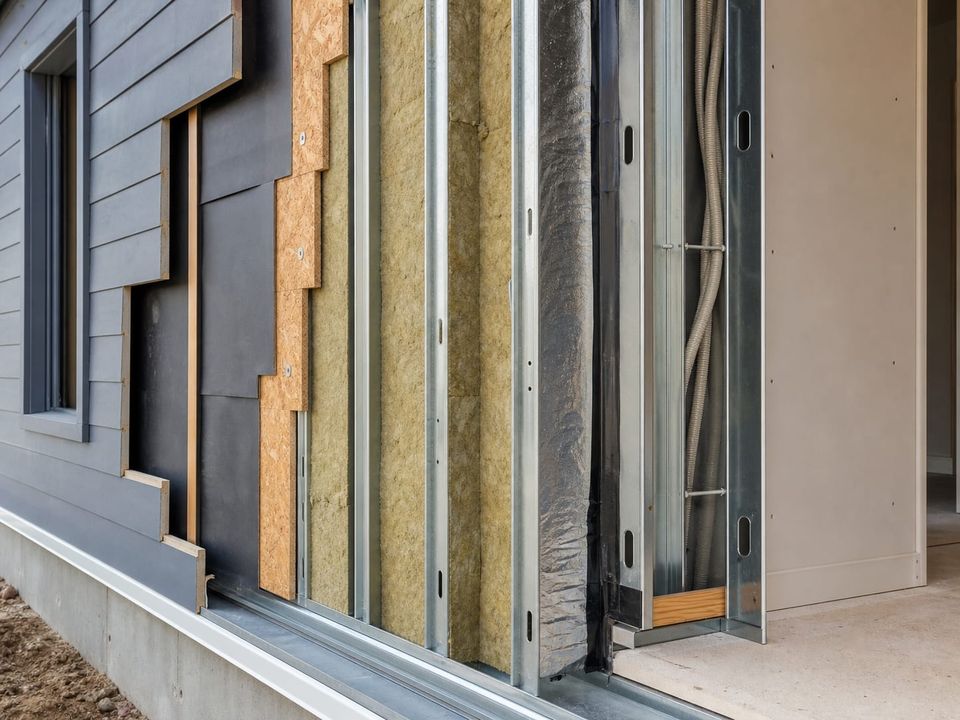

Steel home wall build-up showing insulation layers, vapour control, and external finish
Performance belongs to the complete assembly including junctions, so build-ups are specified layer by layer rather than by naming a single product.

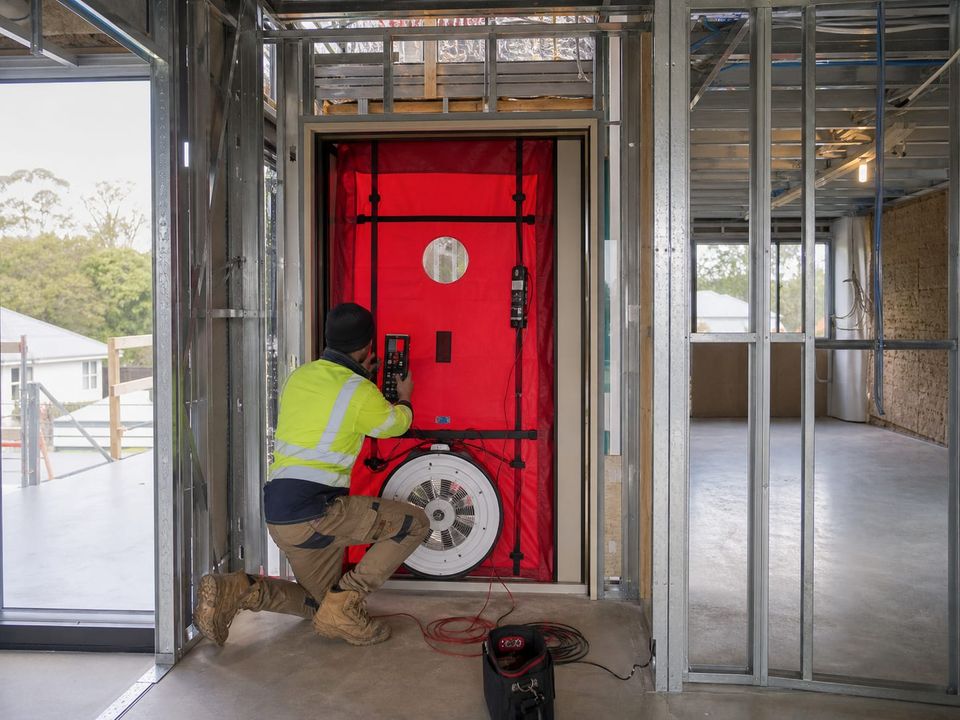

Air tightness test being carried out on a completed steel home
A stated air tightness target becomes a delivered outcome only when it is tested at completion, with a defined process if the result falls short.
Reading a specification critically

Check the Junctions, the Thermal Bridging, and Who Verifies What

Start with scope. The document should state whether the house is a permanent dwelling or seasonal accommodation, the occupancy, the number of storeys, the gross and net areas, the design service life, and where the supplier's responsibility ends and the client's begins.

Then check whether performance is described as assemblies or as products. A quoted U-value that names an insulation board tells you very little; the same value quoted for a complete wall build-up including the effect of the steel framing tells you what the house will actually do.

Fire and acoustic requirements should reference tested assemblies. Where a fire-resisting construction is specified it must be reproduced exactly as tested, including board type and thickness, fixings, joint treatment, and penetration sealing, with substitutions requiring written approval supported by equivalent evidence.

Finally, look for named responsibility. Who calculates the structure, who investigates the ground, who obtains approvals, who inspects at each hold point, who carries out the air tightness and electrical tests, and which documents are issued at handover should all be recorded rather than assumed.

What separates a real specification

Measurable Requirements With Named Verifiers

A specification is only useful when every requirement is expressed as something that can be measured, inspected, or certified, and someone is named to do it.

01

Assemblies, not products

Performance belongs to a complete build-up, not to an insulation board or a panel in isolation. A specification should describe the whole wall, roof, and floor assembly including junctions, or the stated values will not be achieved.

02

Thermal bridging stated explicitly

Because steel conducts heat, a U-value calculated without accounting for the frame is misleading. The specification should state how bridging is handled and whether quoted values include the effect of the framing.

03

Fire performance by tested assembly

Steel loses strength when heated, so protection comes from the lining. Where a fire-resisting construction is required, the tested assembly must be reproduced as tested, including board type, fixings, joint treatment, and penetration sealing.

04

Acoustic targets and how they are met

Lightweight construction transmits sound differently from masonry. Airborne and impact sound targets, the build-ups that deliver them, and any flanking paths should be recorded rather than left to assumption.

05

Corrosion and design service life

Coating class, exposure category, cut-edge protection, fixing compatibility, and cavity ventilation are what determine how long the frame lasts. Service life should be stated together with the conditions it assumes.

06

Verification and responsibility

Every requirement needs a named verifier. Who calculates, who inspects, who tests, who certifies, and who obtains approvals should be recorded, along with the documents issued at each stage.

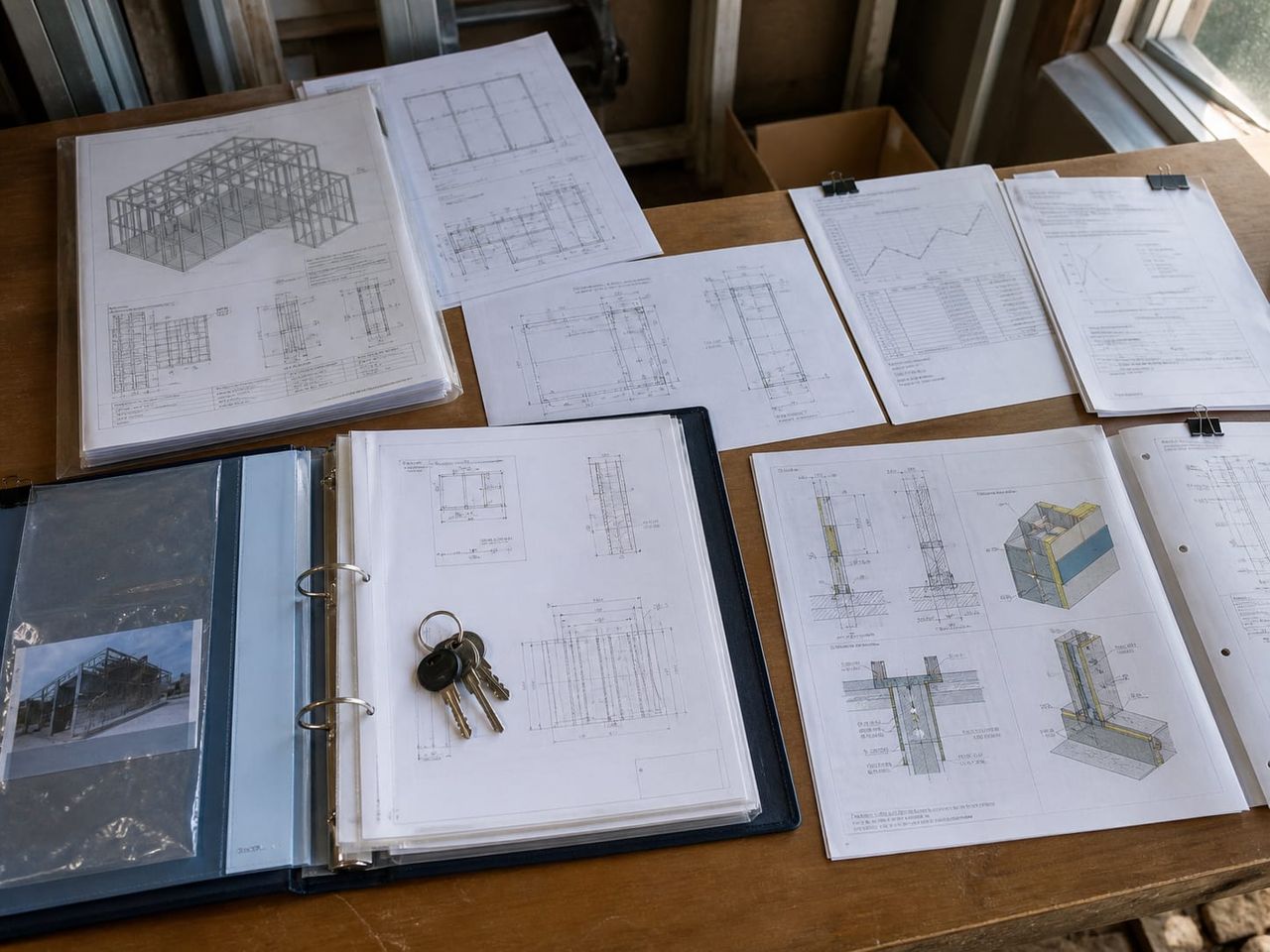

Steel home handover documentation including drawings, calculations, and certificates
Handover documentation should include structural calculations, as-built drawings, test and commissioning certificates, the maintenance manual, and a written warranty scope.
Specification before price

What Should Be Agreed Before a Steel Home Quotation?

A meaningful quotation answers a specification covering scope, structural basis, materials and protection, envelope performance, services, compliance, testing, and warranty. Comparing prices without one compares scopes rather than houses.

01Scope definition

Use, occupancy, storeys, areas, design service life, and the boundary between supplied works and client responsibilities.

02Structural basis

Design standard, seismic and wind parameters, imposed loads, deflection and vibration limits, and the verifying engineer.

03Materials and protection

Steel grade, section sizes, coating class, connection type, fixing compatibility, cut-edge treatment, and traceability requirements.

04Envelope performance

Assembly build-ups, insulation values, thermal bridging treatment, air tightness target, glazing performance, and acoustic targets.

05Services provision

Electrical scope, heating and cooling capacity, hot water, ventilation strategy, plumbing, drainage, controls, and certification.

06Compliance and approvals

Applicable codes, fire requirements, energy performance obligations, accessibility, permits, inspections, and who obtains each.

07Testing and documentation

Inspection hold points, tests to be carried out, certificates issued, as-built drawings, commissioning records, and the maintenance manual.

08Warranty and aftercare

Warranty scope and duration, exclusions, response times, spare parts, maintenance obligations, and alterations requiring prior approval.

Build a clear, comparable project scope.

Specification questions

Steel Home Technical Specifications FAQ

Clear answers about what a specification must contain, assemblies versus products, thermal bridging, fire and acoustic evidence, verification responsibility, and warranty scope.

Why is a written specification necessary?

Because terms such as well insulated, high quality, or earthquake resistant are not comparable between suppliers. A specification replaces them with values, standards, and the method by which each will be demonstrated, which is what makes two quotations answer the same question.

Should performance be quoted for products or assemblies?

For complete assemblies including junctions. A U-value quoted for an insulation board tells you very little; the same value quoted for the whole wall build-up, accounting for the steel framing, tells you what the house will actually do in use.

How should thermal bridging be addressed?

Explicitly. Because steel conducts heat, a U-value calculated without accounting for the frame is misleading. The specification should state how bridging is handled and whether the quoted values include the effect of the framing rather than leaving it ambiguous.

How should fire performance be specified?

By reference to a tested assembly. Steel loses strength when heated, so protection comes from the lining system. Where a fire-resisting construction is required it must be reproduced exactly as tested, including board type and thickness, fixings, joint treatment, and penetration sealing.

What should the structural section contain?

The design standard, the seismic parameters for the specific site, wind and snow actions, imposed loads, deflection and vibration limits, the bracing and hold-down arrangement, the foundation and anchorage basis, and the name of the engineer verifying the design.

How is corrosion protection specified?

Through steel grade, galvanised coating class matched to the exposure category, cut-edge treatment, fixing compatibility, and cavity ventilation. Design service life should be stated together with the conditions it assumes, since those conditions are what make it achievable.

Who is responsible for verification?

Every requirement needs a named verifier: who calculates, who investigates the ground, who obtains approvals, who inspects at each hold point, who carries out air tightness and electrical testing, and which documents are issued at each stage.

What should the specification say about handover?

It should list the inspection hold points, the tests to be carried out and certificates issued, as-built drawings, commissioning records, the maintenance manual, warranty scope and duration with exclusions, spare parts, and which alterations require prior approval.

Tell us aboutyour project.

Send the intended use, the site, the occupancy, and the date it needs to be working. We come back with the scope we would price.

Talk it through
Prefer to explain the project on a call?
0850 000 00 00
Send the brief
Drawings, a room schedule, or a short note.
info@example.com

1234 Example Street, Suite 100, 34000 Istanbul, Türkiye

or email us: info@example.com
